What Is RFP In Project Management? How-To Guides & Samples [2024]

Sep 16, 2024

about 7 min read

services-header-img

Learn what an RFP in project management is, why it's important, and how to create one in 2024. Read now!

What Is A Request for Proposal (RFP) in Project Management?

A Request for Proposal (RFP) in project management is a formal document issued by an organization to solicit proposals from potential vendors or service providers.

request for proposal in project management definition

The purpose of an RFP is to gather detailed information about the services, solutions, or products that vendors can offer to meet the specific needs of a project.

This process is crucial for ensuring that the organization selects the best possible vendor based on a thorough evaluation of various proposals.

The RFP process typically involves several steps, including:

  1. Preparation: Identifying the project needs and drafting the RFP document.
  2. Distribution: Sending the RFP to selected vendors or making it publicly available.
  3. Proposal Submission: Receiving and reviewing proposals from vendors.
  4. Evaluation: Assessing the proposals based on predefined criteria.
  5. Selection: Choosing the vendor that best meets the project's requirements.
  6. Contracting: Finalizing the terms and conditions and signing the contract with the selected vendor.

Why Is RFP in Project Management Important?

An RFP in project management is crucial for ensuring your projects run smoothly, on time, and within budget.

It clearly outlines what the project needs, helping everyone involved understand their roles and reducing the chance of confusion. And with detailed requirements, vendors can create proposals that meet your project's exact needs, leading to better quality outcomes.

Moreover, creating an RFP encourages multiple vendors to compete, offering their best solutions and prices. This competition can lead to cost savings and innovative ideas. An RFP, in addition, provides a structured way to evaluate proposals, allowing you to compare options fairly and make informed decisions.

The RFP process also helps you spot potential risks early on. Vendors explain how they will handle challenges and reduce risks, giving you insight into their problem-solving abilities.

What Are The Key Components of an Effective RFP?

An effective RFP ensures clear communication of all necessary information and helps the organization receive comprehensive and competitive proposals.

An effective RFP in project management typically consists of the following components:

1. Statement of Purpose

The statement of purpose provides a clear and concise explanation of why the RFP is being issued.

It outlines the primary objectives of the project and what the organization aims to achieve by engaging with potential vendors. This section sets the tone for the entire RFP and helps vendors quickly understand the project's overarching goals.

2. Background Information

The background information section offers context about the organization and the current environment to define any challenges and needs. It includes details such as the company’s history, the existing systems in place, and any relevant past projects.

3. Project Objectives

Clearly defining the project objectives is the first step in drafting an effective RFP. This section should provide an overview of the project, including its purpose, goals, and desired outcomes.

🖊️ Example

"Our organization aims to implement a new Customer Relationship Management (CRM) system to improve customer service and sales tracking.

The goal is to enhance customer satisfaction by providing better support and to increase sales efficiency by automating tracking and reporting processes. We expect the new CRM system to integrate seamlessly with our existing software and provide real-time data analytics capabilities."

4. Scope of Work

The scope of work section details the tasks and responsibilities expected of the vendor. It outlines the specific activities that need to be completed, the expected deliverables, and any particular methodologies or standards that should be followed.

This section ensures that vendors have a clear understanding of what is required to complete the project successfully.

🖊️ Example

"The selected vendor will be responsible for:

  • Analyzing our current systems and processes.
  • Recommending a suitable CRM solution.
  • Implementing the CRM system.
  • Integrating it with our existing ERP and email systems.
  • Providing training to our staff.
  • Offering ongoing support and maintenance."

5. Detailed Requirements

This section outlines the specific requirements of the project in detail. It should cover all aspects of the project, including technical specifications, functionality, performance criteria, and any other relevant details. This section allows vendors to develop precise and tailored proposals.

🖊️ Example

"The CRM system must include the following technical specifications:

  • Cloud-based solution accessible from multiple devices.
  • Integration with our existing ERP and email systems.
  • Features such as lead tracking, customer segmentation, and automated reporting.
  • Performance criteria: The system should handle a minimum of 10,000 customer records without performance degradation.
  • Additional requirements: User-friendly interface, Mobile app support for iOS and Android."

6. Evaluation Criteria

Specifying the criteria by which proposals will be evaluated is crucial for ensuring a fair and transparent selection process. This section should list the factors that will be considered, such as technical expertise, experience, pricing, timeline, and any other relevant attributes.

🖊️ Example:

"Proposals will be evaluated based on the following criteria:

  • Technical Expertise: Proven experience in implementing CRM systems.
  • Experience: At least 5 years in the industry and successful completion of similar projects.
  • Pricing: Total cost of ownership within the budget range of $50,000 - $100,000.
  • Timeline Adherence: Ability to complete the project within 6 months.
  • Additional Attributes: Customer support availability, user training programs, and scalability of the solution."

7. Timelines

This section should include:

  • Proposal Submission Deadline: Specify the due date for proposals (e.g., 30 days from RFP issuance).
  • Evaluation Period: Provide the timeframe for reviewing proposals (e.g., 2 weeks).
  • Vendor Selection Date: Indicate when the decision will be made (e.g., within 1 month after the evaluation period).
  • Project Start and End Dates: Outline the expected project timeline (e.g., project to start within 2 months of vendor selection and complete within 6-12 months).

8. Budget Constraints and Payments

This section outlines the financial terms and conditions for the project, including the budget range or limits and the payment schedule. It provides details on milestone-based payments or installment plans and any specific invoicing requirements.

Transparency about budget expectations and payment terms helps vendors propose solutions that fit within the financial parameters and understand how and when they will be compensated for their work.

🖊️ Example

"The project budget is estimated to be between $50,000 and $100,000. Payment will be structured as follows:

  • 20% upon signing the contract.
  • 30% upon completion of the initial implementation phase.
  • 30% upon successful integration with existing systems.
  • 20% upon project completion and final acceptance. Invoices should be submitted at each milestone for payment processing."

What Are The Steps To Create An RFP?

Creating a Request for Proposal (RFP) involves several key steps that can be structured into three main phases: before creation, during creation, and after creation.

Before you create an RFP

1. Define the Project Scope and Objectives

Identify the specific needs and goals of the project, determine the desired outcomes and performance standards.

2. Gather Background Information

Collect relevant data about your company and the project's context, understand the existing systems and processes that will be impacted.

3. Identify Stakeholders and Form a Team

Identify all stakeholders involved in the project, form a team responsible for developing and managing the RFP.

4. Establish a Timeline and Budget

Set a realistic timeline for the RFP process and project execution, determine the budget constraints for the project.

During RFP creation

1. Draft the RFP Document

  • Statement of Purpose
  • Company Background
  • Project Objectives
  • Scope of Work
  • Detailed Requirements
  • Detailed Requirements
  • Evaluation Criteria
  • Timelines
  • Budget Constraints and Payment

2. Review and Revise the Draft

Share the draft with stakeholders and team members for feedback, make necessary revisions to ensure clarity and completeness.

3. Prepare Supporting Documents

Gather any additional documents or appendices that should be included (such as technical specifications, compliance requirements, etc.) ensure all supporting materials are accurate and relevant.

After creating the RFP

1. Distribute the RFP

Send the finalized RFP to selected vendors or make it publicly available, make sure vendors have sufficient time to prepare their proposals.

2. Manage Vendor Inquiries

Provide a point of contact for vendors to ask questions, respond to inquiries promptly and transparently.

3. Evaluate Proposals

Review and score proposals based on the predefined evaluation criteria, shortlist vendors that best meet your requirements.

4. Conduct Vendor Interviews and Demos

Schedule interviews or demos with shortlisted vendors, assess their capabilities and fit for the project.

5. Select the Vendor and Negotiate the Contract

Choose the vendor that best meets the project needs., negotiate the contract terms and finalize the agreement.

6. Communicate the Decision

Notify all participating vendors of your decision through emails or other communication channels, provide feedback to unsuccessful vendors if requested.

Sample of RFP In Project Managements

a sample of request for proposal in project management

Template of RFP In Project Managements

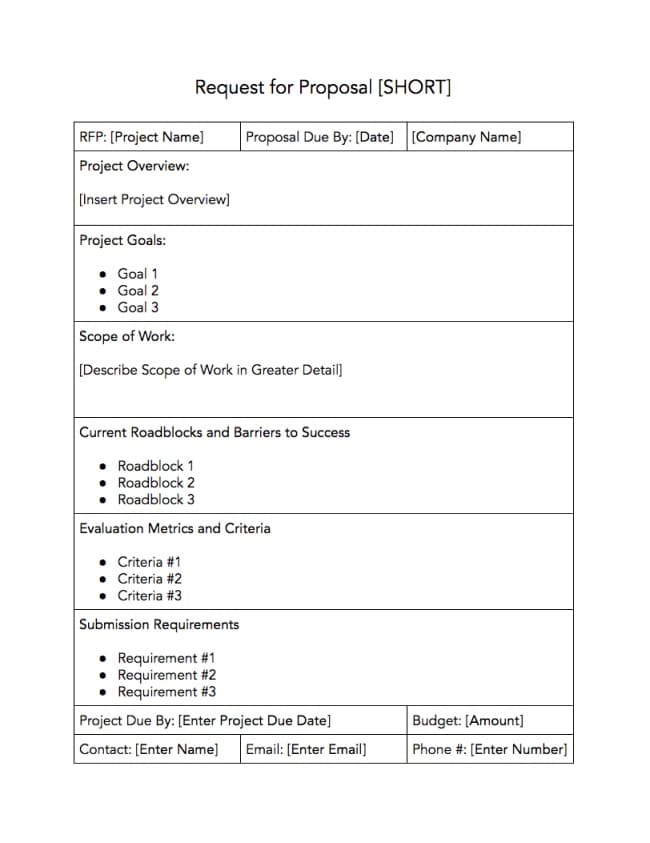

a short template for rfp in project management

How to Improve Your Proposal Process with Project Management?

Before submitting your proposal, take the time to perfect it. Thoroughly review and revise it to catch any errors or inconsistencies.

Start by clearly defining your project tasks and objectives. This clarity sets the foundation for success. Use tools like Trello, Asana, or Microsoft Project to organize everything, from set up timelines, manage budgets, and keep track of tasks efficiently.

Using standard templates can save a lot of time and ensure consistency. Customize them to fit each specific project. This way, you maintain a professional look while tailoring the content to meet unique needs.

Assign roles and responsibilities so everyone knows what they need to do and when, ensures that everyone is working towards the same outcome.. Create a project brief and establish goals that align with your client's expectations.

Involve your team and stakeholders from the start to foster a sense of ownership and collaboration. Also, regular feedback sessions are vital to discuss progress and make any needed adjustments.

Leading to the last point (but not least): Communication and collaboration are key. Keeping everyone accountable and aligned with the project's goals ensures smooth execution.

Bottom Line

Nailing the RFP in project management can transform your overall management game. Keep refining your approach, stay open to new ideas, and you'll see your proposals and projects soar to new heights. 2024 is your year to shine in project management!

We hope this article have been helpful for you! Get more insights and expand your knowledge with Golden Owl's Blog.

liner

Our latest posts

latest-postWeb Development

Ecommerce ERP Integration Explained: Features, Benefits, and Case Study (2024)

Reimagine your business flow with ecommerce ERP integration—connecting the dots between inventory, sales, and finance for seamless growth.

Sep 10, 2024

about 7 min read

latest-postIT Consulting

12 Inspiring Examples of MVP from Industry Leaders (2024)

Discover 12 inspiring examples of MVP from industry leaders like Netflix, Facebook, and Amazon. Learn how MVPs can turn simple ideas into world-class innovations.

Aug 5, 2024

about 7 min read

latest-postIT Consulting

Proof of Concept vs. Prototype vs. MVP: Is It ‘Worth’ The Build? (2024)

How to choose between a Proof of Concept vs. Prototype vs. MVP for your startup? Learn the key differences, benefits, and how each approach can benefit you in this article.

Jul 26, 2024

about 7 min read

dialog

Subscribe to Golden Owl blog

Stay up to date! Get all the latest posts delivered straight to your inbox
messenger icon
